Ready mix concrete · Recycled aggregate

Concrete never dies. It comes back as the next pour.

We deliver ready-mix concrete, and we take broken concrete back. Demolition rubble is crushed, the steel is lifted out, and the rock is graded into certified aggregate for the next load out of the gate.

100%max recycled coarse aggregate in the mix
0tonsaccepted concrete to landfill
1.4tonsiron ore saved per ton of steel recovered
6movesfrom rubble to ready-mix
One gate, two yards

Drive in once. There are two yards behind the scale.

The front yard batches and delivers ready-mix concrete. The back yard takes broken concrete in, crushes it, pulls the steel out and grades the rock. What leaves the back yard is what goes into the front yard’s drum.

The front yard

Ready‑mix

Cement, water, sand, rock, and a truck that shows up. Everything in this yard is pointed at the gate.

  1. Sales officeThe pitch
  2. Mix boardThe mixes
  3. Batch houseBatching
  4. DispatchDelivery
  5. Scale houseThe ticket
Sales officeThe pitch

Ready-mix concrete, delivered to spec.

Six mix designs, one plant, our own drivers. Structural, flatwork, pumped and high-early concrete batched by computer to ASTM C94 tolerances and hauled on Hill Mix trucks — never brokered. Tell us the strength, the exposure and how it is going in the ground, and we will write the mix and put it on your job inside the 90-minute clock.

  • Six designs, 3,000 to 6,000 psiAir-entrained, fiber-reinforced, pumpable and high-early, proportioned per ACI 211 and broken per ASTM C39.
  • Our trucks, our drivers10 cu yd drums spaced to your placement rate, with the ETA texted from the yard.
  • The recycled line is on the ticketUp to 100% recycled coarse aggregate on standard mixes, printed on every load with the source ledger number.
Mix boardThe mixes

Six mixes. Pick the number, we’ll write the rest.

Every design is proportioned to the job, not pulled off a shelf: exposure, placement method, finish and schedule all move the numbers. These are the six we run every week, and each one is submitted on a mix design sheet for your engineer before the first truck leaves the plant.

Give us the strength, the exposure, the cubic yards and the pour date and a mix design sheet comes back the same day — with the recycled-aggregate percentage your specification will carry already written on it.

  1. 3,000psi HM‑3000

    Footings, foundation walls, thickened edges, fill. The load that leaves the gate most days.

    • ¾ in coarse
    • 4 in slump
    • non‑air
    • 28‑day
    RCA up to 100%
  2. 3,500psi HM‑3500 AE

    Driveways, sidewalks, curb and gutter — anything that will see a freeze and a de‑icer.

    • ¾ in coarse
    • 4 in slump
    • air‑entrained 5–7%
    RCA up to 100%
  3. 4,000psi HM‑4000

    Slabs on grade, structural footings, tilt‑up panels, light commercial. The workhorse.

    • ¾ in coarse
    • 5 in slump
    • non‑air
    RCA up to 100%
  4. 4,500psi HM‑4500 P

    The pump mix. Walls, columns, congested reinforcement, elevated decks — designed to go up a 4 in line without segregating.

    • ⅜ in pea gravel
    • 6 in slump
    • mid‑range water reducer
    RCA up to 75%
  5. 5,000psi HM‑5000 F

    Warehouse and industrial floors. Fiber for crack control in place of welded wire.

    • ¾ in coarse
    • 5 in slump
    • 4 lb/cu yd macro fiber
    RCA up to 50%
  6. 6,000psi HM‑6000 HE

    Fast‑track slabs, post‑tension, precast beds, cold‑weather placement. Strip forms Thursday for a Monday pour.

    • ¾ in coarse
    • 5 in slump
    • high‑early, 3‑day
    RCA up to 30%

That right‑hand column is the only one another plant can’t print. It is rock we crushed ourselves — and the higher the design strength, the more conservative we get, because a recycled mix that misses its break isn’t recycling, it’s a callback.

Slump measured at the point of placement per ASTM C143. Air content per ASTM C231. Cylinders cast per ASTM C31 and broken at 7 and 28 days per ASTM C39. Low‑shrinkage, integral‑color, lightweight and flowable‑fill designs on request.

Batch houseBatching

The load is right before it leaves the yard.

A mix design is a promise on paper. What lands on your grade is whatever the plant actually weighed. So we weigh it, print it, and hand you the numbers.

Every material is weighed on its own load cell against a batch computer, and the cells are calibrated on schedule with the certificates on file at the plant. Moisture probes in the sand and rock bins read free water as the material is drawn and take that water back out of the batch, so a 5 in slump is a 5 in slump whether the stockpile has been rained on since Tuesday or baked dry since Friday.

±1%Cement
±2%Aggregate
±1%Water
±3%Admixture

ASTM C94/C94M batching tolerances. Actual batch weights print on your ticket, not a summary of them.

Design water is held back at the plant. If a load needs water on site we add it once, before discharge, up to the design water‑cement ratio, then turn 30 revolutions at mixing speed per ASTM C94 — and the addition is printed and signed for. Water past that is your call, and it comes off our strength warranty. We would rather send a second truck.

Cylinders are cast per ASTM C31, cured, and broken at 7 and 28 days. Break sheets go to whoever signed the ticket and to the engineer of record, not just into our file. Wash water is clarified in a closed circuit and rebatched, and every aggregate we batch — quarried or recycled — is graded to the same ASTM C33 envelope. Same test, same paperwork, either source.

DispatchDelivery

The clock is our service area, not the map.

ASTM C94 gives a load 90 minutes or 300 drum revolutions from batching to complete discharge, whichever lands first. Everything about how we schedule works backwards from that number.

Tell us your placement rate in cubic yards per hour and we set the interval between trucks to match it — a pump crew at 40 cu yd/hr and a wheelbarrow crew at 6 do not get the same spacing. Hot weather we chill the water and ice the batch per ACI 305; cold weather we heat the water and accelerate per ACI 306, and we will move your start time to protect the pour. Every truck is GPS‑tracked and the ETA is texted to whoever is running the pour, so nobody stands in a form waiting. Washout comes back to our yard, not onto your slab, unless you want it on site.

Ordering, in five moves.

  1. 01Tell us the pourStrength, exposure, how it is going in the ground, and what the truck has to get through to reach you. Five minutes on the phone.
  2. 02We write the mixDesign, admixtures, slump at the point of placement, and how much recycled coarse aggregate your specification will carry. Submitted for your engineer.
  3. 03Book the slot48 hours ahead for anything over 20 cu yd. Same day when the plant has the window — call and ask; the answer is often yes.
  4. 04We batch and haulWeighed to C94, loaded, and on the road with the ETA texted from the yard.
  5. 05You get the paperA ticket per load, cylinders if you want them, break results emailed at 7 and 28 days.

And whatever comes back in the drum at the end of the day is washed out into our own reclaimer and crushed with everything else in the back yard. Returned concrete is not a loss here. It is next week’s aggregate.

Scale houseThe ticket

Everything we claim fits on one piece of paper.

A delivery ticket is the only document that connects what you specified to what actually came out of the chute. Ours is printed to be read — and one line on it is the reason the rest of this website exists.

Ticket
418‑2207
Plant
Hill Mix · Front yard
Batched
09 Sep 2026 · 07:12
Truck · driver
14 · R. Alvarez
Job
Cedar & 9th — slab on grade
Mix
HM‑4000 · 4,000 psi · ¾ in · 5 in slump
Load · to date
9.0 cu yd · 27.0 of 42.0 cu yd
Design water
31.5 gal, held at the plant
Water added on site
0 gal
Air · concrete temp
2.1% · 78 °F
RCA content
62% recycled coarse aggregate
Source ledger
RC‑4412 · Riverside deck, demolished 12 Aug 2026
Cylinders
Set of 4 cast 07:41 — 7 / 28 day
The 90-minute clock starts here Real batch weights, not a summary Water you add on site is your signature This line came from the back yard

Ledger RC‑4412 was a parking deck on Riverside. You can follow it through the back yard, machine by machine — and if the pile it came from is on the ground when your truck loads, that number is on your ticket too.

Cross to the back yard ↓
Everything we make comes off this pile ↑ Everything we take back goes onto it ↓
The crossing

One pile. Two yards.

The front yard draws from it. The back yard fills it. The ground changes colour at this line for the same reason the paper does — above it is the copy that leaves with the truck, below it is the yard’s own. Everything under this line is how the rock gets made.

The back yard

Recycling

Where the last building comes in on a truck and leaves as rock. Everything in this yard is pointed at the crusher.

  1. The gateWhat we take
  2. Tip floorWhy it matters
  3. Crushing lineThe six moves
  4. Steel bunkerThe steel loop
  5. StockpilesThe grades
  6. Front yardThe return
The gateWhat we take

Bring us your broken concrete.

We accept clean demolition concrete and returned ready-mix at the gate, crush it, pull the steel out and grade the rock back into certified aggregate. Nothing we accept goes to landfill, and everything we accept is on its way to a stockpile the front yard draws from. Ledger RC‑4412 started here.

  • Clean concrete onlyNo mixed construction waste. Rebar in the concrete is fine, we pull it.
  • Weighed and ticketedWeighed in and weighed out on the same certified scale, photographed at the gate, ticket emailed the same day.
  • At the gate6:30 a.m. to 4:00 p.m. weekdays, Saturday mornings by arrangement. Call ahead for anything over 200 tons so we can stage the pile.
  • What we turn awayAsphalt, brick, block, dirt, wood, mesh rolls, coated slabs, anything with visible hazardous material. Rejected loads are turned at the scale, not dumped and argued about later.
  • Certified back out¾ in structural, ⅜ in pea gravel and manufactured sand, sampled and tested every 500 tons.
Tip floorWhy it matters

The world is built on concrete. Then we throw its value away.

Concrete is the most consumed man-made material on Earth. When a structure comes down, most of that mass is dumped or downcycled, while quarries blast fresh rock for new aggregate and mines dig fresh ore for new rebar.

Both ends of that equation are broken, and both are fixable with the same plant. The rock in demolished concrete is still rock. The steel inside it is still steel. Our job is to send both back into structural service, engineered to each project's specification, not downgraded to road base.

We can't yet recycle the cement itself; nobody can at scale. But aggregate is roughly two-thirds of concrete's volume, and the rebar is, pound for pound, the most energy-expensive material in the structure. Aggregate is where the tons are; the recovered steel is where the avoided carbon is.

33B tons / yrConcrete consumed worldwideRoughly 33 billion tons poured every year, more than all other building materials combined.
600M tons / yrUS construction & demolition debrisUS EPA estimate, about twice the country's municipal garbage. Concrete is the single largest share.
65%Of concrete's volume is aggregateThe rock and sand: fully recoverable, and exactly what we return to the mix.
Crushing lineThe process

From rubble to ready-mix in six moves.

One continuous line. Concrete goes in broken; it leaves as specification-graded recycled aggregate and clean steel. Hover the plant to find each station, then scroll: you run every machine. Six machines, all of them dry — nothing in this chapter is wet until the last one.

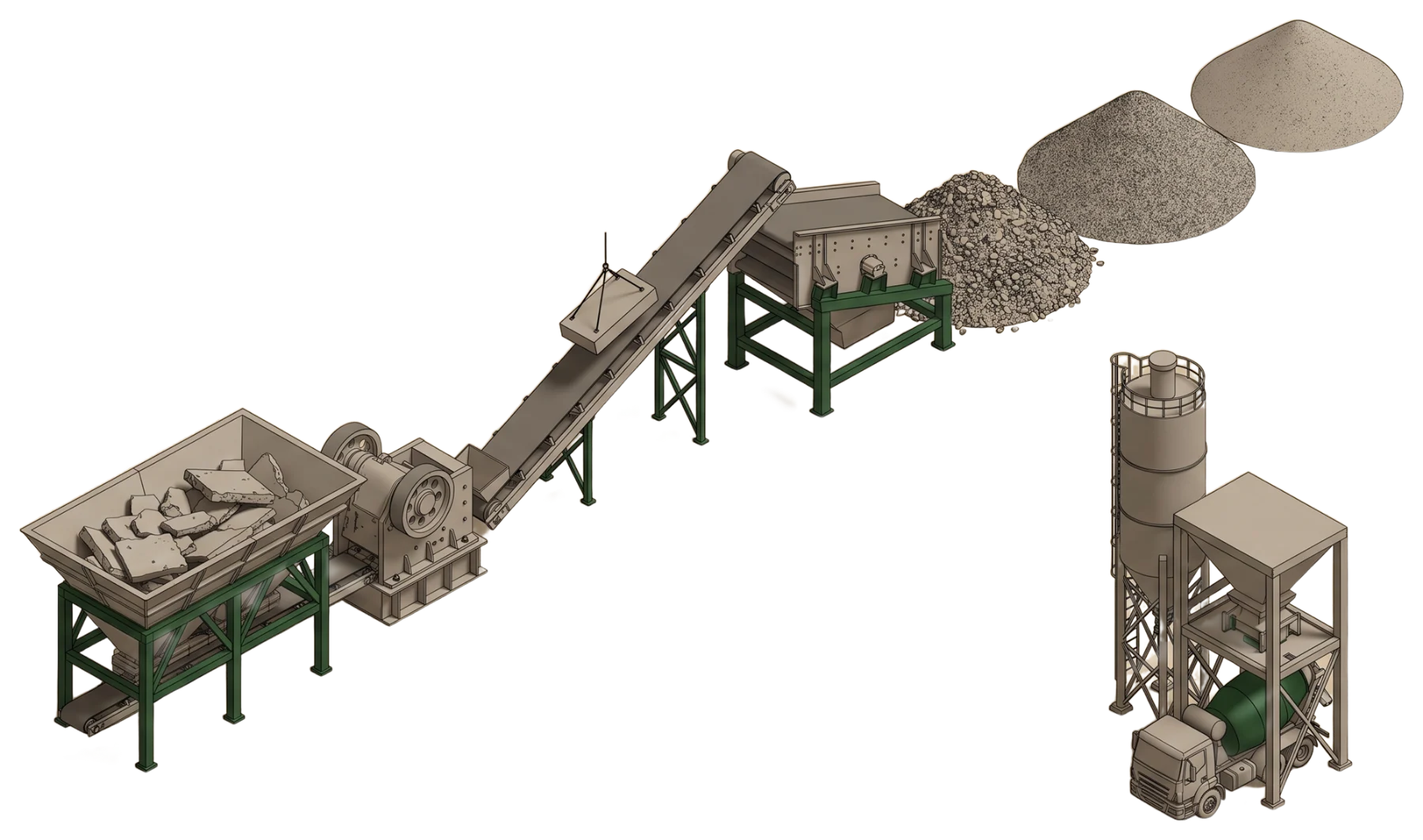

Isometric drawing of the Hill Mix line: intake hopper, jaw crusher, conveyor with overband magnet, triple-deck screen, three graded stockpiles and the ready-mix batch plant
01

Intake — the rubble arrives

Intake — the rubble arrives
Process line — sht 01 / 06 Rev A · for review
01 / INTAKE — ACCEPTANCE SOURCE: DEMOLITION + RETURNED READY-MIX QA SCAN UNSORTED C&D CONCRETE — AS RECEIVED A A — EXPOSED REBAR, TYP. // EVERY LOAD WEIGHED, PHOTOGRAPHED & TICKETED PROCESS LINE — SHT 01 / 06 STAGE: INTAKE + QA SCALE: NTS REV A — FOR REVIEW DWG 100-01

Demolition concrete and returned ready-mix arrive as mixed rubble, rebar still buried inside. Every load is weighed, photographed and digitally ticketed at the gate, then scanned for contaminants before it touches the line. Clean concrete only. No mixed construction waste.

  • Source-verified loads
  • Digital chain of custody
  • Contaminant screening
02

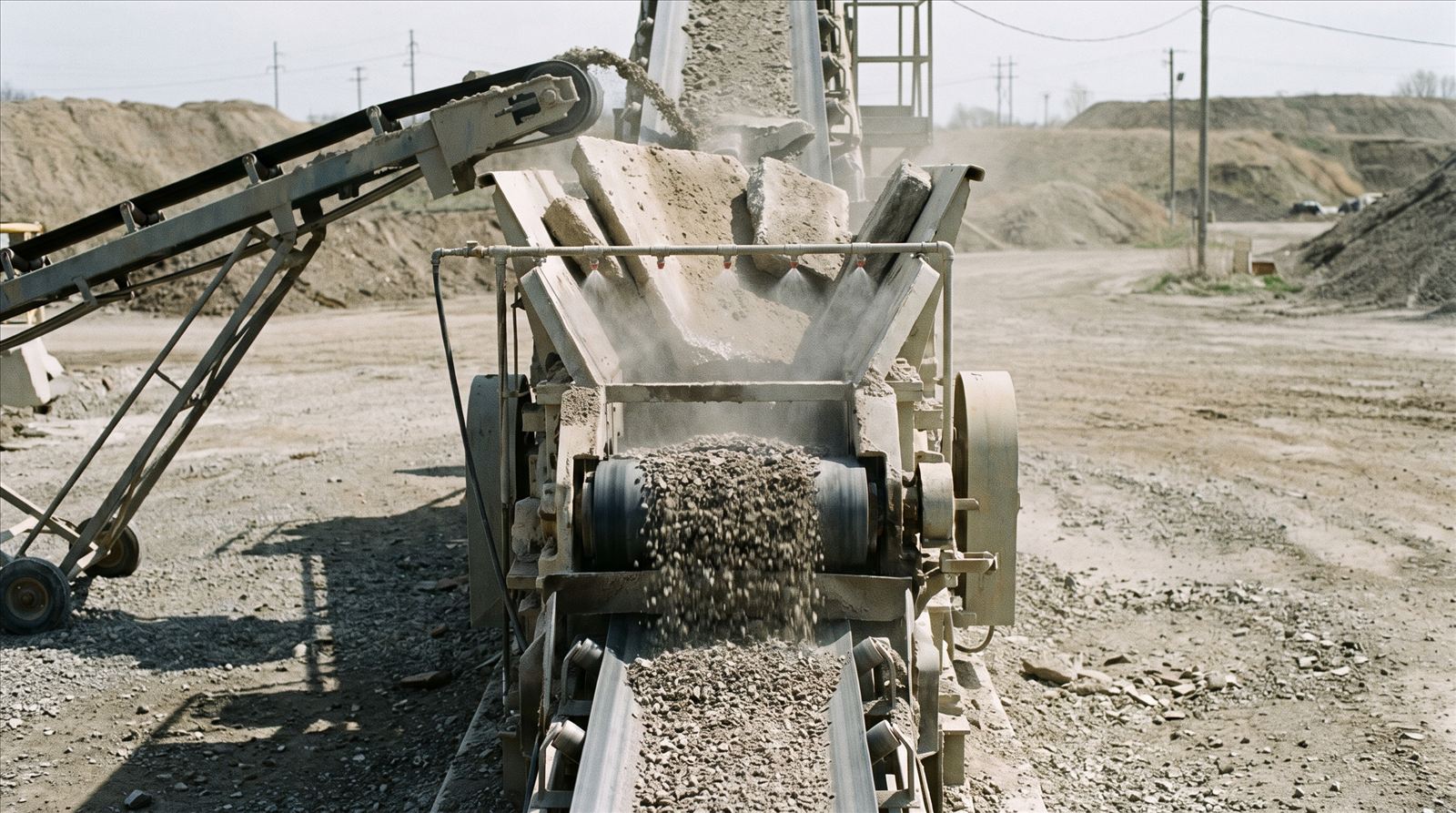

Crush — primary reduction

Crush — primary reduction
Process line — sht 02 / 06 Rev A · for review
02 / JAW CRUSHER — PRIMARY REDUCTION FEED: SLABS TO 32 IN // PRODUCT: MINUS 1½ IN FEED HOPPER FLYWHEEL — 320 RPM B CSS = 1½ IN MINUS 1½ IN → EXTRACT B — TOGGLE PLATE + CSS ADJUST // WATER MIST DUST SUPPRESSION AT THROAT PROCESS LINE — SHT 02 / 06 STAGE: CRUSH SCALE: NTS REV A — FOR REVIEW DWG 100-02

A jaw crusher does the heavy work: slab-sized pieces go in the top, a reciprocating jaw plate breaks them against a fixed one, and everything leaves at minus 1½ in. Crushing also strips the rock from the rebar, which is exactly what the next station is waiting for. Water mist at the throat keeps dust at the source.

  • Slab → 1½ in in one pass
  • Liberates rebar from rock
  • Mist dust suppression
03

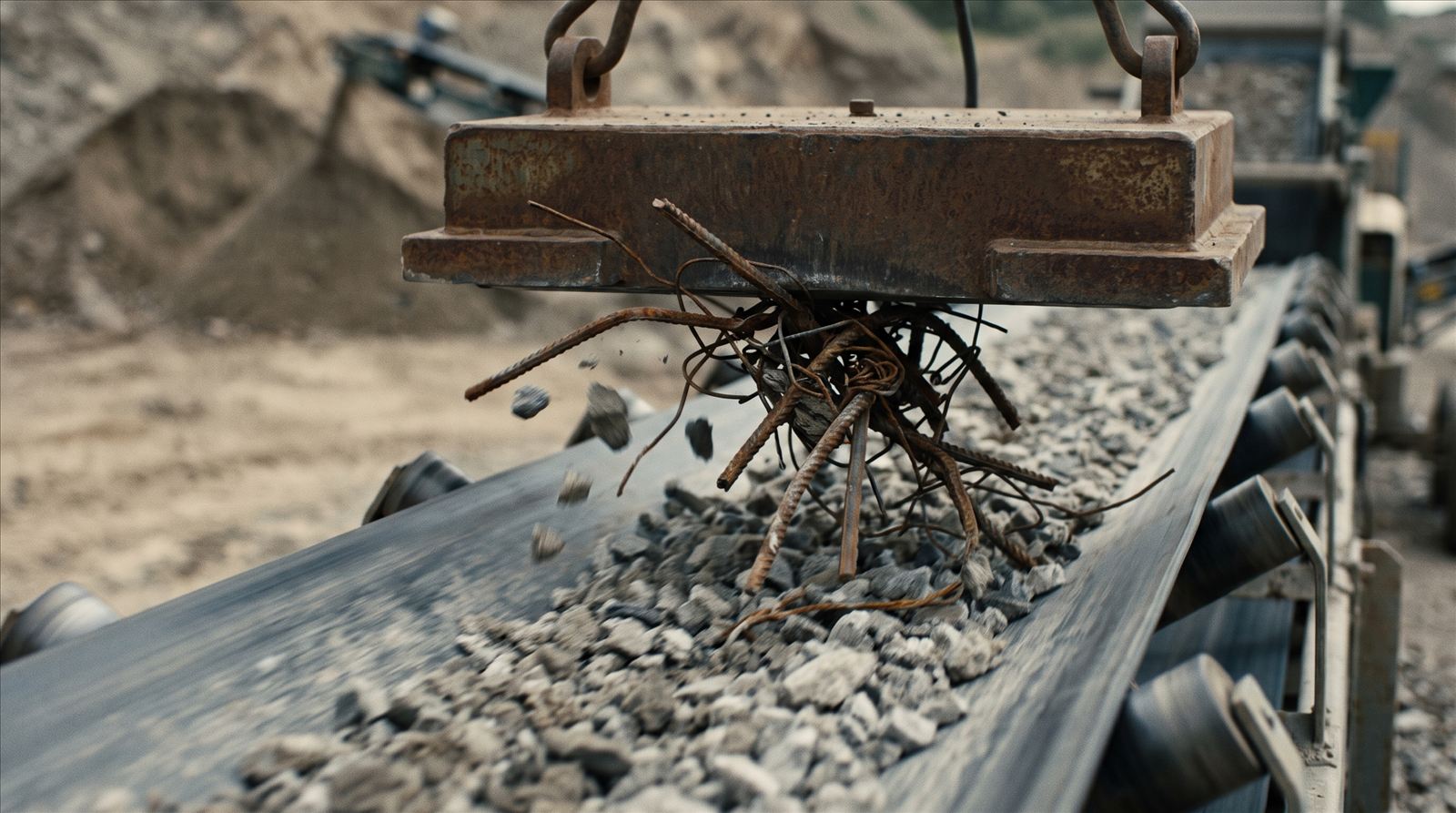

Extract — the steel lifts out

Extract — the steel lifts out
Process line — sht 03 / 06 Rev A · for review
03 / MAGNETIC SEPARATION OVERBAND MAGNET — SELF-CLEANING CROSS-BELT MAGNET REBAR → STEEL LOOP CLEAN FEED → SCREEN FE RECOVERY ≥ 98% TYP. HEAD-PULLEY MAGNET + HAND-PICK QA DOWNSTREAM FIELD: 9 500 G — ENERGIZED C C — SELF-CLEANING OVERBAND MAGNET // 1 TON STEEL ≈ 1.4 TONS IRON ORE UNMINED PROCESS LINE — SHT 03 / 06 STAGE: EXTRACT SCALE: NTS REV A — FOR REVIEW DWG 100-03

This is the move that makes the loop close. A suspended overband magnet hangs across the conveyor; as the crushed burden passes underneath, every piece of rebar, wire and tie lifts clean off the belt onto the magnet's own cross-belt and is thrown to the steel bin. The rock never stops moving. Typical ferrous recovery is 98% and better, with a head-pulley magnet and a hand-pick station catching the stragglers.

  • Overband + head-pulley magnets
  • ≥98% ferrous recovery typ.
  • Recovered steel goes to the mill
04

Screen — sorted by size

Screen — sorted by size
Process line — sht 04 / 06 Rev A · for review
04 / TRIPLE-DECK VIBRATING SCREEN CLEAN MINERAL FEED — FOUR SIZED PRODUCTS OUT FEED — MINUS 1½ IN, STEEL-FREE EXCITER — 8G ¾ IN ⅜ IN NO. 4 PAN — MANUFACTURED SAND +¾ IN → RE-CRUSH D D — INTERCHANGEABLE PU MESH DECKS // OVERSIZE LOOPS BACK TO THE CRUSHER PROCESS LINE — SHT 04 / 06 STAGE: SCREENING SCALE: NTS REV A — FOR REVIEW DWG 100-04

The steel-free rock rides onto a triple-deck vibrating screen: three stacked mesh decks shaking at eight times gravity. Big stones stay on top, each deck below catches a finer cut, and anything still oversized loops straight back to the crusher. Out the other side: four clean, sized products and no mineral waste stream.

  • Four sized products
  • Oversize auto-returns
  • No mineral waste stream
05

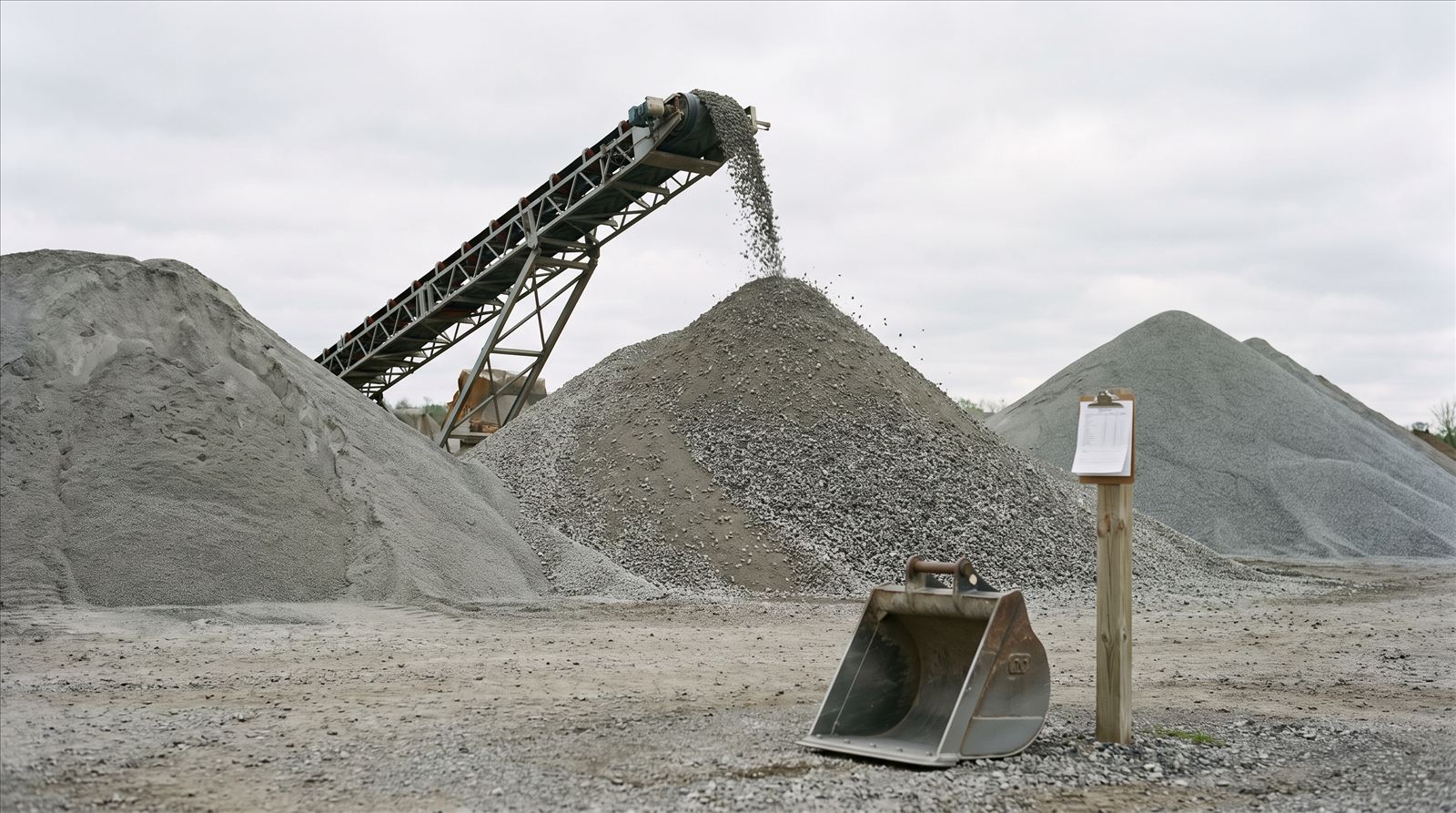

Grade — certified stockpiles

Grade — certified stockpiles
Process line — sht 05 / 06 Rev A · for review
05 / GRADED STOCKPILES — RCA RECYCLED CONCRETE AGGREGATE, SAMPLED EVERY 500 TONS RADIAL STACKER ¾ IN STRUCTURAL ⅜ IN PEA MANUFACTURED SAND GRADATION — ASTM C33 ENVELOPE EVERY STOCKPILE CARRIES A GRADATION CERT + EPD DATA SHEET // SAMPLED & LAB-TESTED EVERY 500 TONS PROCESS LINE — SHT 05 / 06 STAGE: GRADE + QC SCALE: NTS REV A — FOR REVIEW DWG 100-05

The sized rock lands in certified stockpiles: ¾ in structural, ⅜ in pea gravel, and manufactured sand (No. 4 minus). Every 500 tons is sampled and lab-tested against the same gradation envelopes as quarried stone, because recycled aggregate that can't meet spec isn't recycled, it's downcycled. Ours ships with the paperwork to prove it.

  • Tested to virgin-aggregate spec
  • Gradation cert per stockpile
  • EPD data on request
06

Remix — back into the build

Remix — back into the build
Process line — sht 06 / 06 Rev A · for review
06 / BATCH PLANT — READY-MIX OUT COARSE AGGREGATE: UP TO 100% RECYCLED (RCA) RCA 20 RCA 10 WEIGH HOPPER ±0.5% LB CEM + SCM H₂O — RECLAIMED WASH WATER TO SITE BATCH TICKET #0001 VOLUME: 12.0 m³ COARSE AGG: RCA 20/10 — 100% STEEL: 0.00% // SLUMP: 4¾ IN SEQ: AGG → WEIGH → CHARGE EVERY BATCH TRACEABLE TO ITS SOURCE DEMOLITION // WASH WATER RECLAIMED IN CLOSED CIRCUIT PROCESS LINE — SHT 06 / 06 STAGE: DISPATCH SCALE: NTS REV A — FOR REVIEW DWG 100-06

The graded recycled aggregate goes straight into the batch plant. Gate A opens, gate B follows, the scale settles, and the whole weighed charge drops into the turning drum, blended with cement and reclaimed wash water. The truck that leaves can carry concrete with up to 100% recycled coarse aggregate, matched to the project's specification and traceable on the ticket back to the building it used to be. The loop is closed.

  • Up to 100% recycled coarse agg
  • Closed-circuit wash water
  • Ticket-level traceability
Steel bunkerThe steel loop

Every bar we pull is ore that stays in the ground.

Pound for pound, rebar is the most energy-expensive material in a demolished building. Making new steel from ore means mining iron, mining coal, and running a blast furnace. Remelting recovered rebar in an electric arc furnace skips all three.

The steel we lift off the belt is sheared, baled and sent straight to the mill, where it becomes new rebar, beams and mesh with no loss of strength. Steel is one of the only materials on Earth that recycles forever.

1.4tonsof iron ore left unmined for every ton of steel recycled (worldsteel)
~1,480lbof coal not burned per ton of recycled steel (worldsteel)
steel remelts forever with no loss of strength. Today's rebar is tomorrow's rebar.
StockpilesThe grades

Three grades of rock. One source: the last building.

Every stockpile carries a gradation certificate and an EPD data sheet. Sampled and lab-tested every 500 tons against the same envelopes as quarried stone. These three piles are the front yard’s shopping list — sold on their own by the ton, and charged straight into the drum by the truckload.

Pile of ¾ inch recycled concrete aggregate
¾in
Structural coarse aggregate

The workhorse. Up to 100% replacement of quarried coarse aggregate in ready-mix, matched to the project's specification.

Pile of ⅜ inch pea-sized recycled aggregate
in
Pea gravel

For pumped mixes, thin sections and congested reinforcement. Same certification, finer cut.

Pile of manufactured sand, recycled concrete fines
#4minus
Manufactured sand

Manufactured sand from the same rock. Used in the mix and in base courses where spec allows.

Front yardThe return

The rock goes back in.

Recycled aggregate isn't our end product. New concrete is. The crushed, cleaned, graded rock is charged straight back into the ready-mix drum, so the next pour is made of the last building.

ReclaimYesterday's structure: crushed, cleaned, certified, and drawn from the stockpile.
RebatchWeighed to ±0.5% and charged into the drum as spec-graded coarse aggregate.
RebuildPoured into the next structure, which is itself a future stockpile.

Ticket 418‑2207 said RCA 62%, source ledger RC‑4412. That was 5.6 cu yd of a parking deck going back into a slab on grade at Cedar & 9th, twenty-eight days after it came down. The loop is not a diagram on this page. It is a line on your ticket.

Back to the mixes ↑
The circular economy, in one ring

We didn't invent the loop. We closed the leak.

Drag the ring · scroll to spin it · click a card to jump to that move

ESG, built in, not bolted on

Responsible from the first ton.

Recycling is our product, not our PR. These are the standards the plant is being designed to: published now, audited once we're running.

EEnvironmental
  • 100% of accepted concrete diverted from landfill, by design, not by target
  • No blasting, no quarry haul: recycled aggregate from inside the city it serves
  • Closed-circuit wash water, reclaimed and reused, batch after batch
  • Dust misted at source, noise engineered down, both monitored at the fence line
  • Electric-ready plant: crushing and screening built to run on grid power
SSocial
  • Skilled local jobs: operators hired and trained in the communities we serve
  • Zero-harm safety program from day one: everyone home, every day
  • Published fence-line commitments on noise, dust and truck traffic
  • Urban recycling means shorter hauls: fewer heavy-truck miles past homes and schools
  • Open doors: site tours for schools, neighbors and local officials
GGovernance
  • Every load digitally ticketed: chain of custody from demolition to new pour
  • Third-party-verified environmental product declarations (EPDs)
  • Annual public impact report: tons in, tons out, carbon avoided
  • Board-level ESG oversight with independent review
  • No greenwash rule: nothing claimed that a ticket can't prove
Landfill diversion, accepted concrete100%
Renewable plant power, 2030 target100%

Design targets for our first plant. Once operating, actuals are published annually, misses included.

Impact

The math of the loop.

What one thousand tons of demolition concrete becomes when it comes through our gate instead of being buried or ground down to road base.

980tonsrecycled aggregate returned to new concrete
20tonssteel recovered & sent to the mill
Per 1,000 tons of demolition concreteTypical quantityWhat it replaces
Recycled aggregate → new ready-mix≈ 980 tonsQuarried virgin stone
Recycled coarse aggregate batched into Hill Mix loads≈ 980 tonsQuarried stone bought from someone else
Rebar & wire → electric-arc mill≈ 20 tonsBlast-furnace steel from ore
Iron ore left in the ground≈ 28 tons1.4 tons per ton of steel (worldsteel)
Coal left unburned≈ 15 tons1,480 lb per ton of steel (worldsteel)
To landfill0 tonsLandfilling, or downcycling to road base: the usual fate

Typical values. Rebar content varies by structure (roughly 1–2% by mass). Actuals are reported per project, ticket by ticket.

Get involved

Bring us your rubble.

Demolition contractors, developers, municipalities, ready-mix producers, investors: if concrete is coming down near you, it should be coming to us. Let's close the loop together.

  • Demolition contractors
  • Developers
  • Municipalities
  • Ready-mix producers
  • Investors
Talk to Hill Mix
Gate hours
6:30 a.m. to 4:00 p.m. weekdays. Saturday mornings by arrangement.
Lead time
48 hours ahead for anything over 20 cu yd; same day when the plant has the window. 35-mile haul radius, farther with a retarder agreed at booking.
We take
Clean demolition concrete and returned ready-mix. No mixed construction waste.
We supply
¾ in, ⅜ in and manufactured-sand certified recycled aggregate, and ready-mix with up to 100% recycled coarse aggregate.
Paperwork
Digital ticket per load, gradation certificate per stockpile, EPD data on request.
